Custom Bronze Sculpture

What Actually Changes a Bronze Sculpture's Timeline

Every bronze sculpture runs on a different schedule. Here is what actually moves the date, and why we do not publish a number before we have seen your design.

bronze-sculpture-wax-pattern-repair
When you're planning a custom bronze sculpture, the first question usually isn't about the casting method or the patina.
It's "When can we have it?"
That matters whether you're ordering a single bespoke piece, developing a product line, planning a hotel installation, or placing an OEM production order. A missed date can affect an opening, an exhibition, a trade show, or a retail release.
So let's answer it honestly, which means not with a number.
This page will not quote you a lead time. Here's why, and here's what we can tell you instead.

What actually determines the timeline

Four things move a bronze sculpture's schedule. None of them is size alone.
Where the design starts. A production-ready 3D file skips straight to pattern making. A sketch, a photograph or a half-formed idea needs modelling work first, and that work cannot be compressed by asking nicely.
Whether the model has to change. Almost every file needs something adjusted before it casts cleanly — wall thickness, undercuts, structural stiffness. If those changes are agreed before the master is made, they cost time once. If they arrive after the pour, they cost you a new master, and probably a new sample.
How many approval rounds happen. Every project has at least one. A design approval, a physical sample, a patina reference, sometimes a second sample. Each one waits for a decision, and the schedule waits with it.
What the surface work asks for. A standard brown patina and a two-tone piece with a hand-worked highlight are not the same number of hours on the bench.

The stages of a custom bronze project

A bronze sculpture doesn't go from a drawing to a finished casting. Between those two points sit several stages, and each one moves at its own speed.

1. Project brief and technical review

Every project starts with something — drawings, reference images, an existing 3D file, a specification sheet, or one sentence describing what you want.
At this point we need more than the look of it. Size, intended use, quantity, finish, installation requirements, indoor or outdoor, and whether this is a one-off or a production run all change how we approach it. Whether you'll approve a physical sample, and when.
An incomplete brief doesn't cost extra money. It costs rounds.

2. Design development and 3D modeling

Skip this stage if you already have a production-ready model. Otherwise it involves concept work, models, rendered views, dimensioned specifications, and the structural adjustments mentioned above.
This is also where revisions happen, and revisions are normal. One or two rounds is ordinary for bespoke work. The problem is never the first round — it's the fifth one arriving after the master was cut.

3. Master pattern, wax pattern and shell

Once the design is approved, the master and the shell system get prepared for lost-wax casting.
This is the least glamorous stage and the one that decides whether the surface you asked for survives. The mould has to hold the detail of the original while still releasing from it. Deep undercuts, hollow sections, multiple components and large works all make the shell more complicated.

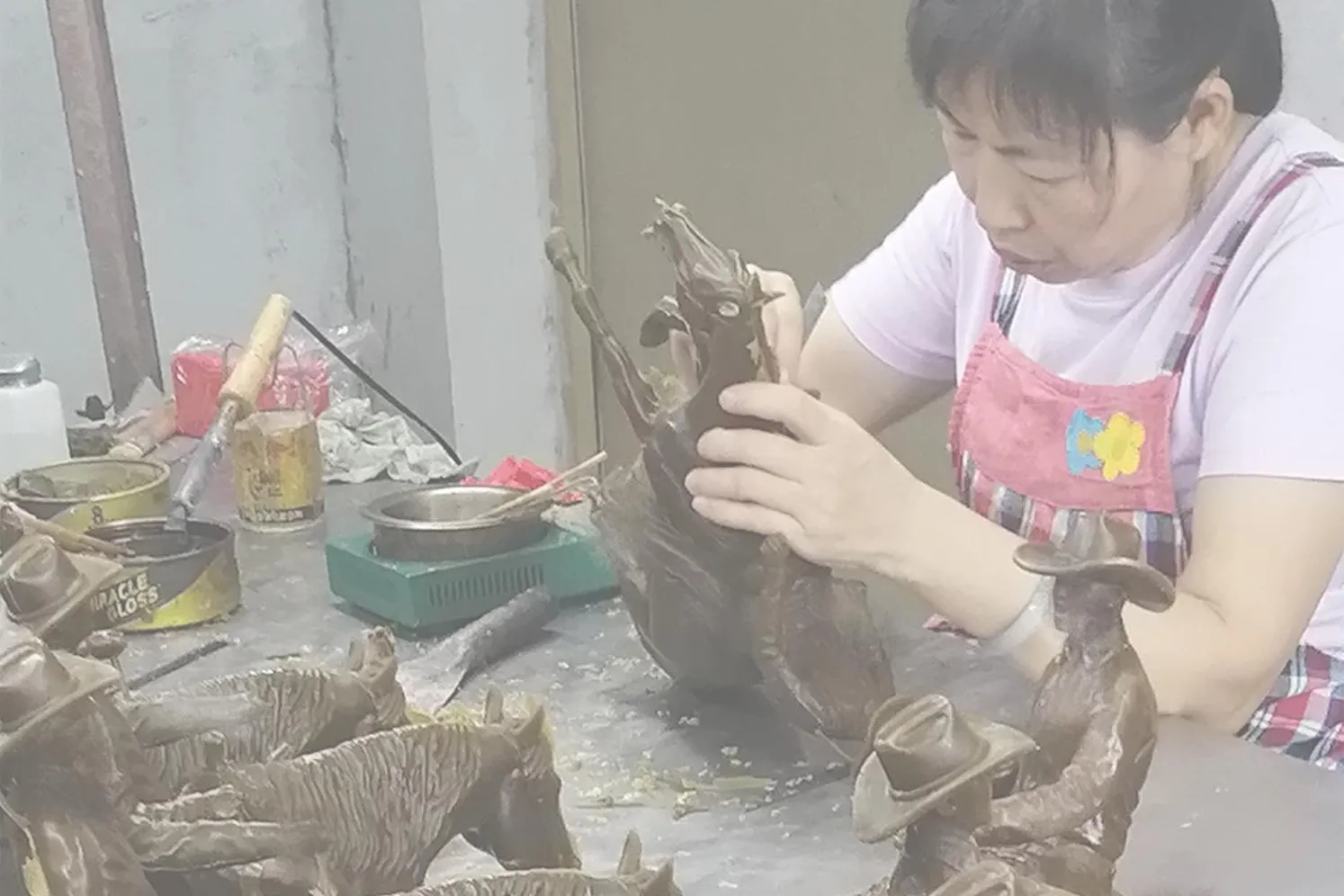

After the shell work, wax patterns are produced and checked before any metal is involved.
Our shell is built in five ceramic layers, air-dried between each. That detail matters later — see the section on wet weather below.

4. Sample and approval

For OEM and ODM work, and for anything you intend to repeat, the physical sample is the checkpoint that matters most.
The first sample lets you judge the actual object rather than a rendering. Proportions, surface detail, dimensions, assembly, base or mounting, patina colour, texture, branding.
If it meets what was agreed, production moves. If it doesn't, the schedule moves with it — and a change to the model or the mould means back to stage 3.
A minor finishing adjustment is quick. A structural one is not.

5. Casting, finishing and production

Once the sample is approved, the real work starts: wax preparation, casting, cutting and chasing, welding, grinding, polishing, surface finishing, patination, assembly and final detailing.
Production time depends on far more than quantity. A small run of relatively simple pieces moves quickly. Five large, heavily detailed sculptures can take longer than twenty small ones — because each one carries more casting and more hand-finishing hours.
Count, scale, complexity, component count and finishing requirements all factor in. OEM runs can also plan differently from one-off commissions, because pieces move through the same stages together.

6. Final inspection, packing and shipment

Before anything leaves the workshop it gets checked for appearance, dimensions, finish, assembly and packing.
Export packing for a large piece takes planning of its own. Crate type depends on the sculpture's size, structure, weight, number of sections and destination.
Keep two dates separate: the day it leaves the factory, and the day it reaches you. They are not the same deadline, and treating them as one is how projects go wrong quietly.

What usually causes a project to take longer

In our experience delays rarely come from one big failure. They come from several small things accumulating.

Design revisions

Changing the design after modeling has started can touch the 3D model, the master, the wax, and sometimes the casting process itself.

Sample changes

If the first sample isn't approved, another round begins. Changes to proportions, details, patina or structure each push the schedule differently.

Slow approvals

This is the easiest delay to avoid, and the most common.
If a design, a sample photo or a finish needs your approval, production cannot move until the decision comes back. Each individual wait may look trivial. Three of them in a row do not.

Complex construction

Large pieces, multi-part works, enclosed forms, deep undercuts and complicated assemblies all need more production planning than a simple solid form.

Quantity

A single commission and a fifty-piece OEM order should not be expected to run the same way.
But quantity doesn't scale production time proportionally. Once the master, tooling and procedures exist, pieces often move more efficiently as a batch.

Peak periods

Foundries get busier at certain points in the year, especially when several commercial, hospitality, award and retail projects land together.
Chinese New Year matters too. Operations pause around the holiday, so any project crossing it needs to be planned with that in mind rather than discovered later.

Utility supply and grid load

Bronze melting draws heavily on power, and we do not pour on a generator — the temperature control is not good enough for a sound casting. Scheduled grid maintenance or load-shedding in an industrial zone can pause a pour for several days. We plan furnace slots around it rather than gamble a casting on it.

Inspections

Foundries in China are subject to environmental and fire-safety inspections that are, by design, unannounced. When an inspection is called, work in the casting bay stops until clearance is given. There is no way to work around this, and we would not want to.

Mould drying in wet weather

This is the one that matters most for quality, and the one buyers rarely think about.
Our shell and sand moulds must be completely dry before metal is poured. In a rainy or humid spell, drying simply takes longer. Pour into a mould that isn't fully dry and you get gas porosity, blowholes and surface defects — a casting that fails inspection and has to be melted down and made again.
That costs far more time than the days it would have saved.

Can it be made faster?

Sometimes. But speeding up a bronze project doesn't mean skipping the steps that make it good.
The easiest time savings come from better preparation and faster decisions, not from asking the foundry to hurry.
You can shorten a schedule by:
  • Sending complete reference material at the start
  • Confirming dimensions early, not at quotation stage
  • Providing production-ready 3D files if you have them
  • Limiting changes after the design is agreed
  • Giving consolidated feedback instead of separate small messages
  • Approving samples promptly
  • Confirming patina and finish before production starts
  • Planning shipping before production ends
For genuinely urgent projects, added capacity or expedited logistics can sometimes be arranged, subject to the workshop's own schedule.
But not every stage compresses indefinitely. Casting quality, shell preparation, hand finishing, patina work, inspection and packing all need enough room. Rushing them costs more time than it saves.

Planning backward from your delivery date

If your project has a fixed deadline, don't start by asking "how fast can you make it?"
Start with the date you need the sculpture in your hands, then work backward.
International transit → final inspection and export packing → bulk production → sample approval → master and wax preparation → design development → project brief
Looking at it this way tells you something useful: most of the recoverable time sits at the front, in the brief and the design stage. Once metal is involved, your options narrow sharply.
If the deadline is tied to a hotel opening, an exhibition, a trade show, a retail launch or a public installation, tell us that date at the beginning. A schedule built around the actual deadline beats a schedule bolted on after production has started.

One-off commission vs. OEM vs. ODM production

The shape of the timeline depends on what you're buying.
One-off bespoke work carries more design development and more individual hand-finishing. Design and approval can account for much of the total, because the process is concentrated on making one specific object right.
OEM production usually starts from an existing design, sample, drawing or specification. Once the product and process are established, repeat orders are far more predictable — which is the whole point of a production run.
ODM development involves more work at the start, because the design gets built from your brief. The early stages take longer; what comes out is developed for your market rather than adapted to it.
For anyone building a product line, that distinction decides your launch planning.

The biggest mistake is planning to the minimum

If a supplier quotes you the fastest time they could possibly achieve, that is not the same as a date you should build a launch around.
A possible production time and a safe project schedule are different things. A workable plan leaves room for:
  • Design feedback
  • Sample revisions
  • Production adjustments
  • Peak factory periods
  • Packing
  • Transit
  • Unexpected problems
That margin matters more when the sculpture is part of something larger — a lobby opening, an exhibition, a launch date that can't move. Timeline and project cost are closely linked, because every extra revision, every additional finish pass and every expedited production slot shows up in both.
A shorter timeline you cannot keep is worse than a longer one you can. Tell us the real date and we'll tell you honestly whether we can reach it.

How we handle project scheduling

We don't treat every custom bronze sculpture as a standard production item.
Once we understand the design, dimensions, quantity, finish and delivery requirements, we build a project schedule around that actual scope. Our process covers design development, pattern and shell preparation, lost-wax casting, hand finishing, patination, inspection and export preparation.
For OEM / ODM projects, sample approval sits inside the process before any production run begins.
Patina is applied at 18–24°C and 40–50% relative humidity, because humidity is the single biggest variable in whether a patina still looks even in three years. Outdoor and coastal pieces get an additional anti-corrosion treatment.
We keep clients posted at the major stages and flag problems early — early enough for you to make a decision, rather than discovering the problem when the date is already close.

What to send us if you want a usable answer

A realistic answer depends on information only you have. The more of this we get at the start, the more specific we can be:
  • Reference images or sketches
  • 3D files, if available
  • Approximate dimensions
  • Quantity
  • Intended application
  • Indoor or outdoor installation
  • Preferred finish, with patina references
  • Base or mounting requirements
  • Target delivery date
  • Shipping destination
You don't need everything finalized before contacting us. A good custom bronze sculpture manufacturer can tell you which of it is essential now and which decisions can wait.

Final takeaway

There is no single number for a bronze sculpture, and anyone who gives you one before seeing your design is guessing about your project rather than planning it.
What we can give you, once we have the drawings or the 3D file and know the quantity, finish and delivery requirement, is a schedule for your sculpture — and an honest answer about whether your deadline is reachable.
If you have a fixed date, the safest approach is to start early, send a clear brief, keep approval decisions moving, and leave room in the plan for things nobody can schedule around.
Planning a custom bronze sculpture, OEM product or ODM project? Send your drawings, reference images, dimensions or project brief, and we will review the production requirements and tell you what the schedule for your piece actually looks like.
